10 Questions To Ask a Software Development Company Before Hiring

Know what to ask, what evidence to request, and which commitments to put in writing before choosing a development partner.
2,856
10 Questions To Ask a Software Development Company Before Hiring
Frosina Stojchevska
By , Senior Content Editor

The most useful questions to ask a software development company cover the people doing the work, delivery decisions, testing, security, pricing, ownership, and support. Ask for evidence behind each answer and put commitments that affect cost, access, or delivery in the agreement.

The interview should establish how that team will handle your project when requirements change, an integration fails, or a key developer leaves.

This guide combines practical evaluation questions with insights to help you compare agencies before signing.

What To Ask a Software Development Agency: Key Findings

  • Verify the assigned team, relevant experience, first-release plan, and technology choices because a portfolio alone does not establish project fit.
  • Agree on testing, AI safeguards, pricing, reporting, and change approval because delivery claims need evidence and clear responsibilities.
  • Confirm security, confidentiality, ownership, handover, and post-launch support because your business needs to maintain the product and change providers.

93% of Tech Leaders Report Talent Gaps. When Should You Hire a Development Partner?

93% of US tech leaders surveyed by Robert Half said they lacked the staff and skills to meet their 2026 priorities.
A software development company can make sense when a priority project needs skills your team can’t bring in on time.

In a 2026 Robert Half survey of more than 350 US technology leaders, 93% said their teams lacked the staff and skills to meet their priorities for the year.

Say your team can define what a new customer portal should do, but lacks the engineers to integrate it with your billing system and test it before launch.

A development partner can take responsibility for that release while your team sets priorities and decides when the portal is ready for customers.

Start with the gap you need to fill. Then use the questions below to find out who will do the work, what they can deliver, and what they’ll commit to in writing.

Questions To Ask a Software Development Agency at a Glance

Use these software development questions to assess team risk, delivery risk, and exit risk.

Ask shortlisted agencies the same core questions, allow project-specific follow-ups, and compare the evidence behind their answers.

AreaCore questionEvidence to request
TeamWho will work on our project, and how much time will they commit?Staffing plan, confirmed availability, replacement process
ExperienceCan you show relevant work and explain a project that went wrong?Project walkthrough, client reference, evidence behind results
Discovery and scopeWhat would you deliver in the first 90 days, and what would you leave out?Discovery deliverables, unresolved assumptions, release milestones
TechnologyWhich technologies would you choose for our project, and why?Architecture proposal, alternatives, integration and maintenance needs
Testing and acceptanceHow will you test the software and confirm acceptance?Test plan, test results, defect report, release checklist
AI safeguardsWill you use AI coding tools on our project, and what safeguards will you put in place?AI-use policy, approved tools, data-handling settings, reviewed code example
PricingHow will you price the work and approve scope changes?Itemized proposal, recurring costs, change-impact example
ReportingHow will you report progress and escalate risks?Status report, budget forecast, risk register, escalation process
Ownership and handoverWho will own the code and accounts, and how will the handover work?Ownership terms, license inventory, account-access plan, handover checklist
SupportWhat support will you provide after launch?Warranty terms, support agreement, maintenance scope, incident-response procedure

Before the first call, share your intended users, business goals, budget range, launch constraints, existing systems, and data requirements.

A common software development RFP gives each agency the same starting point and makes its proposal easier to compare.

1. Who Will Work on Our Project and How Much Time Will They Commit?

You want to know who will build your product and whether they have time to do it well.

That deserves a clear answer, especially when ManpowerGroup’s 2026 Talent Shortage Survey found that 72% of more than 39,000 employers struggled to fill roles.

AI skills overtook engineering and traditional IT skills as the hardest to find, while the information sector reported the highest shortage rate, at 75%.

Ask the agency to walk you through the proposed team with details on what each person will handle, what relevant experience they bring, and how much time they will commit.

Check who works for the agency, who joins through subcontractors, and who takes responsibility for the work.

You should also know whether you are getting a dedicated team or sharing specialists with other clients. Either arrangement can work, provided the agency explains when those people will be available and how it handles competing demands.

  • Ideal Answer:

Here’s the team we propose, why their experience fits your project, and how much time each person will commit.

You’ll meet your technical lead before we start. We’ll also disclose subcontractors and agree on how we handle replacements, including your approval and the handover.

  • Red Flag Answer:

Our senior team will oversee everything. We’ll decide who’s available once you sign.

Evidence to request

  • A staffing plan showing who does what, their confirmed availability, time-zone overlap, and how the agency handles replacements.

2. Can You Show Relevant Work and Explain a Project That Went Wrong?

Request a project with similar workflows, integrations, scale, or operational constraints. Ask what the agency built, what the client supplied, and how the team measured the outcome.

David Barlev, CEO and co-founder of Goji Labs, says most first calls focus on capability and cost: whether the agency has built something similar, which stack it uses, what it charges, and how long the work will take. In his view:

"Those are fair questions, and they are almost useless as a filter, because every agency worth calling will answer them well."

His suggested question is direct:

“Tell me about a project that went badly and what you did.”

That follow-up tests whether the team can explain a setback, its responsibility, and the changes it made afterward. Ask how it communicated the problem, what it asked the client to decide, and what it changed in later projects.

  • Ideal Answer:

We can walk you through comparable work and explain our contribution.

We can also discuss a project that missed expectations, what we got wrong, how we handled it with the client, and what we changed in our delivery process.

  • Red Flag Answer

All our projects are successful. Our portfolio speaks for itself.

Evidence to request

  • A live or anonymized walkthrough, a client reference where available, and context for any performance claims, including the baseline and measurement period.

3. What Would You Deliver in the First 90 Days, and What Would You Leave Out?

Ask how the agency would turn your business goal into requirements, test important assumptions, and define the first release. Its plan should explain what it needs to investigate before committing to a scope and delivery date.

Discovery should cover users, workflows, integrations, dependencies, and success measures. Ask which outputs you would receive and which decisions your team would need to make before development begins.

Barlev explains why he challenges large initial scopes:

“The pattern we see most often is a client who arrives with a feature list and treats scope as the measure of seriousness.

The instinct is understandable, especially when there is board pressure and a date. But a larger scope is usually how a stalled product got stalled in the first place.”

He describes what that pushback looks like in practice:

“On more than one engagement we have gone back with a smaller version than the one we were asked to quote, and said plainly that we would rather deliver something valuable in 90 days and grow it than deliver everything in twelve months and be wrong about most of it.

That is a genuinely risky conversation. We have lost work for it.”

For your project, ask which useful workflow the first release would support, what the agency would defer, and how feedback would shape further development.

Treat 90 days as a planning prompt and ask what your constraints make achievable.

  • Ideal Answer:

We would first agree on the business outcome and investigate the assumptions, integrations, and dependencies that could affect delivery.

Then we would propose a first release around a complete user workflow, explain what we would leave out and why, and agree on how to measure success.

We would confirm whether 90 days is realistic after discovery and use feedback from that release to prioritize what comes next.

  • Red Flag Answer:

Send us your feature list and we will estimate everything. We can work out the business priorities once development starts.

Evidence to request

  • Discovery deliverables, unresolved assumptions, release milestones, and client-side dependencies.

4. Which Technologies Would You Choose for Our Project, and Why?

Your technology choices will stay with you after the agency's contract ends.

Ask how its recommendation will affect your ability to hire developers, maintain the product, and add features later. A niche stack may solve a specific problem, but it can also narrow your options when you need someone else to take over.

The agency should explain how its proposed stack fits your integrations, expected usage, security requirements, hosting constraints, and budget.

For example, Goji Labs built a new mobile platform in React Native for Intterra, an emergency intelligence platform, replacing a legacy system. The platform runs on a single codebase that serves multiple agencies, including Cal Fire, through environment-based configuration.

That choice let Intterra add new agencies without duplicating engineering work.

Look for this kind of reasoning in every proposal: a technology choice tied to a specific business need, with the trade-off explained.

An agency's experience with a particular stack can be an advantage. Still, ask what makes it a good fit for your project and which limitations you would need to accept.

  • Ideal Answer:

We recommend this stack because it fits your integrations, expected workload, and budget. Here are the alternatives we considered and the trade-offs you would be accepting.

We’ve also considered how your team or another provider could maintain it after handover.

  • Red Flag Answer:

We use this stack for every project. It is scalable and future-proof.

Evidence to request:

  • A short architecture proposal explaining the options, integration requirements, maintenance needs, and assumptions behind expected performance.

5. How Will You Test the Software and Confirm Acceptance?

Before agreeing to a delivery date, ask your agency how it will verify that the software meets your requirements and is ready to launch.

With 60% of surveyed organizations reporting that they deployed untested code to production, according to Tricentis’ 2026 Quality Transformation Report, you need clear evidence of what the team has tested before you approve a release.

Start with acceptance criteria, including the conditions a feature or release must meet before your team approves it. Agree on these before development starts, so everyone understands what counts as complete.

Connect those conditions to your software requirements specification.

Ask how the agency will combine automated checks, integration testing, manual exploration, and user acceptance testing. If your product must handle heavy traffic or time-sensitive tasks, ask how it will test performance too.

Clarify who writes the tests, who investigates failures, and which defects block release. You should also know what remains untested and who approves any remaining risks.

  • Ideal Answer:

We agree on acceptance criteria before development starts and test throughout the project. At each release review, we show you the results, explain any outstanding defects or untested areas, and confirm which issues we must fix before you approve the release.

  • Red Flag Answer:

Our developers test their work, and you can report anything you find after launch.

Evidence to request

  • A sample test plan, test results, defect report, and release checklist.
Explore The Top Software Development Companies
Some agencies shown here include sponsored placements
ELEKS is the partner of choice for many leading enterprises, SMEs and technology challengers. We help businesses elevate their value through custom...
At Designli, we turn software into real, revenue-generating businesses and we measure our success by yours. Real users on a working MVP in 30 days...
We work with ambitious startups, global nonprofits, and Fortune 500s to design and develop the websites and software they need.

6. Will You Use AI Coding Tools, and What Safeguards Will You Follow?

SmartBear’s 2026 State of Software Quality and Testing report found that 46% of respondents had shipped AI-generated code that later failed in production.

Ask your agency how it reviews generated code, tests critical workflows, and decides whether a release is ready.

Ask which AI tools the team uses and where it expects them to save time.

Atlassian’s October 2026 research found that 87% of developers say AI helps them ship faster, yet 72% report the same or greater friction across their workflow.

If an agency promises a shorter timeline, ask for evidence from comparable projects. Its estimate should account for code review, testing, and rework, with clear milestones showing when your business will receive usable software.

Clarify who takes responsibility for AI-assisted work. The agency should explain how engineers review changes, verify generated tests against your requirements, and check for security issues. Ask which decisions require a senior engineer’s approval.

  • Ideal Answer:

We use approved AI tools under a written policy and explain where they will support your project. We agree on what code and data those tools can access.

AI-assisted changes go through human review, testing, and security checks, and our engineers remain responsible for the work we deliver.

  • Red Flag Answer:

AI writes and checks most of the code for us, so we can skip much of the usual review and deliver faster.

Software release checklist covering requirements, testing evidence, AI code review, and risk approval.
Evidence to request

  • The written AI-use policy, approved tool list, data-handling settings, and an example of a reviewed and tested AI-assisted change.

7. How Will You Price the Work and Approve Scope Changes?

Ask what the estimate includes, which assumptions could change it, and how the agency bills additional work. Compare proposals against the same scope and conditions.

ModelClarify before signing
Fixed priceIncluded deliverables, acceptance criteria, exclusions, and how changes affect price and dates.
Time and materialsRates, billable activities, forecast updates, spending limits, and approval authority.
Dedicated teamTeam allocation, billing period, minimum commitment, and terms for increasing or reducing capacity.

Then ask about hosting, licenses, APIs, monitoring, security testing, and support. Include these items in your software development budget.

Changes are part of product development. The agency should explain their effect on scope, cost, and delivery before proceeding. That process can include trading one feature for another within the agreed budget.

  • Ideal Answer:

Here are the estimate assumptions, exclusions, and recurring expenses. We assess changes against the agreed scope and explain their cost and timing impact.

Your designated owner approves additional spending before we proceed.

  • Red Flag Answer:

We are flexible. We can handle small changes and discuss the budget if it becomes a problem.

Evidence to request

  • An itemized proposal, recurring-cost list, and redacted change-impact example.

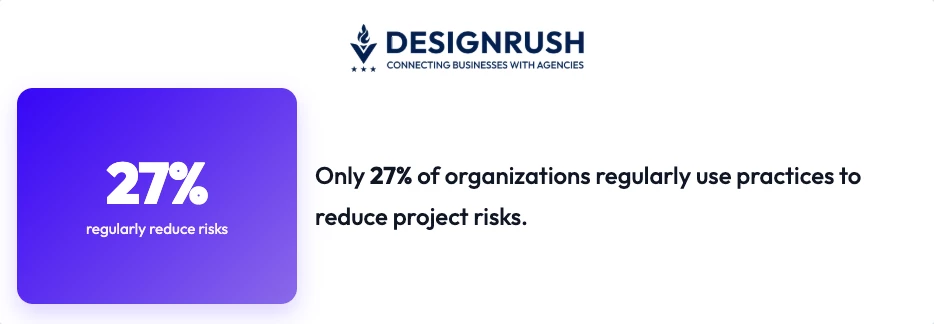

8. How Will You Report Progress and Escalate Risks?

Before signing, ask how the agency will keep you informed about completed work, spending, expected delivery dates, and problems that need your attention.

You should know when you will receive updates and what those updates will contain.

Tempo’s 2026 State of Strategic Portfolio Management report, based on a survey of 667 planning and PMO leaders, found that 82% of respondents with fully integrated portfolio processes reported good or complete visibility across projects, compared with 37% of those with siloed processes.

The finding supports asking how the agency will bring delivery, budget, and risk information together so you can assess your project.

Ask to see a sample report. It should show which deliverables your team has accepted, what remains unfinished, how spending compares with the budget, and whether the expected completion date or cost has changed.

Then ask what happens when something goes wrong. If an integration fails or a specialist becomes unavailable, who would notify you, how quickly, and with what options?

Significant risks should have a named owner, a proposed action, and a clear explanation of the likely impact.

Agree on your responsibilities too. The agency should identify decisions and approvals it needs from your team, their deadlines, and how delays could affect delivery.

  • Ideal Answer:

We agree on a reporting schedule before work starts. Each update shows accepted deliverables, spending, the latest completion forecast, blockers, and decisions we need from you.

If a significant issue threatens the budget or timeline, we contact your named decision-maker promptly with the impact and recommended options.

  • Red Flag Answer:

You can check our task board whenever you want. We’ll let you know if anything major comes up.

Evidence to request

  • A sample status report, budget forecast, risk register, and escalation process.

9. Who Will Own the Code and Accounts, and How Will Handover Work?

Before signing, ask what your business will own, when those rights will transfer, and which project accounts you will control. Agree upfront who will maintain the product after delivery and how the agency will prepare them to do so.

Clarify ownership of custom code, designs, and documentation. Ask the agency to distinguish those deliverables from its existing components and third-party software, including any restrictions on modifying or distributing the product.

Black Duck’s 2026 Open Source Security and Risk Analysis report found license conflicts in 68% of audited codebases, based on an analysis of 947 codebases across 17 industries. Ask how the agency checks licenses and documents the permissions your business receives.

Ownership and access should come with usable documentation and knowledge transfer. Most agencies will tell you knowledge transfer happens throughout the project.

Barlev says that claim alone proves nothing:

"I tell them it is not a phase, it is how we work the whole time, and then I tell them what that looks like concretely, because every agency says the first part."

He also offers a practical test:

“The test I would hold any agency to is simple. If we disappeared tomorrow, could your team deploy a fix on Monday? If the answer is no, the knowledge transfer did not happen, whatever the contract says.”

Software handover checklist showing three tasks your team should perform independently: deploy, restore, and troubleshoot.

  • Ideal Answer:

The agreement specifies what you own, when rights transfer, and which components you license.

Your business controls the core project accounts.

Your engineers join our code reviews from the first sprint, we update runbooks as we build the system, and your team runs deployments before launch.

We also agree on handover requirements and transition terms if the engagement ends early.

  • Red Flag Answer:

Everything stays in our accounts until the end. We’ll send the code and sort out ownership and handover then.

Evidence to request

  • Sample ownership terms, a component and license inventory, an account-access plan, and a handover checklist covering documentation and training.

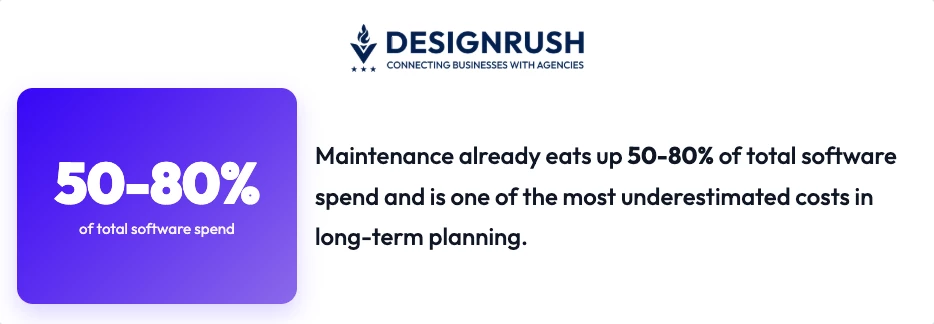

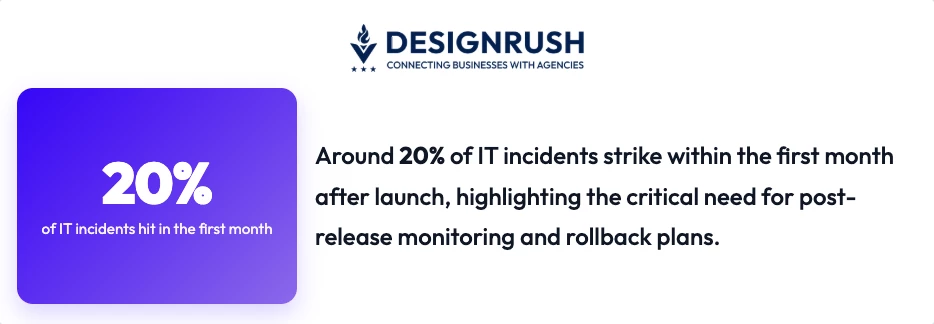

10. What Support Will You Provide After Launch?

Ask the agency to separate its defect warranty, ongoing maintenance, incident support, and new-feature work.

Confirm what each service includes, what it costs, and when responsibility passes to another team.

A service-level agreement, or SLA, should define the service commitments and how the parties measure them. The terms need to distinguish between several different promises.

TermWhat to clarify
ResponseWhen someone acknowledges or begins handling the issue.
RestorationThe target for returning the affected service to operation, possibly through a workaround.
ResolutionHow the provider handles the underlying defect or cause.
CoverageSupport hours, time zones, severity levels, exclusions, and third-party dependencies.

Also, ask who monitors the system, applies patches, checks backups, and leads an incident. Make sure any uptime commitment identifies the services the agency controls.

  • Ideal Answer

We define the warranty and paid support separately. Each severity level has coverage, response and restoration targets, and an escalation owner.

The agreement explains monitoring, maintenance, exclusions, and third-party responsibilities.

  • Red Flag Answer

We are always around. Message us if you need help.

Evidence to request

  • Warranty terms, support agreement, maintenance scope, and incident-response procedure.

How To Compare Software Development Agency Answers

Ask shortlisted agencies the same core questions and record the evidence behind their answers.

Use the following editorial rubric to track confidence and outstanding work; it does not predict agency performance.

ScoreMeaning
0 - UnresolvedThe agency gives no usable answer or relevant evidence.
1 - ExplainedThe answer is specific, but evidence or a written commitment remains pending.
2 - SupportedRelevant evidence supports the answer, and material commitments appear in the draft agreement.

For each topic, record the evidence reviewed, outstanding question, buyer-side owner, and decision date. Mark genuinely non-applicable checks and explain why.

Keep material issues visible outside the total score. Unclear ownership, sensitive-data access, or acceptance responsibility needs resolution before you proceed, even when the agency performs well in other areas.

Adapt follow-up questions to the project:

  • For an MVP, ask which user assumption the first release tests because feature delivery should help the team make its next investment decision.
  • For an integration project, ask who owns migration validation and rollback because external dependencies can affect release readiness.
  • For sensitive-data software, ask what enters development and testing because security requirements depend on the actual data flow.
  • For a takeover, ask how the agency assesses existing code and operations because inherited constraints can change the estimate.

If significant uncertainty remains, consider a bounded paid discovery engagement. Agree on its cost, outputs, rights, and exit terms before treating it as a commitment to the full build.

Software Development Contract Checklist Before Signing

Check that the proposal and contract reflect the agency’s interview answers. Review the master services agreement, statement of work, security terms, and insurance evidence together, and confirm which document takes priority when terms conflict.

Start with these delivery commitments:

  • Confirm roles and availability so staffing promises match the proposed engagement.
  • Define scope, acceptance, and change approval so both teams understand completion requirements and who can authorize additional spending.
  • List recurring charges and account owners so your budget covers operating costs after launch.
  • Confirm ownership, access, exit deliverables, and a practical handover check, so your team or another provider can maintain the product.
  • Assign security and support responsibilities so urgent issues reach a named owner.

Then review the following contract terms with counsel. This section provides general guidance, not legal advice.

Software development contract checklist covering acceptance, hiring restrictions, and financial responsibility.

Find More Agency Hiring Resources:

1. In-House vs. Outsourcing Software Development

2. How To Plan a Software Development Budget

3. Building a Practical Budget for Mobile App Development

Choose a Development Partner Who Can Handle a Change of Plan

Before you make your final decision, give each shortlisted agency the same scenario from your project. If a critical integration slips by a month, what could they still ship on time? What would change in the budget, and what would they need you to decide?

Compare how each team handles that trade-off. Then put the commitments that drove your choice in the statement of work, so both sides know what to do when the plan changes.

Next step: Want help building a shortlist? Our team ranks software development agencies worldwide. Get proposals from verified agencies.

Visit our Agency Directory for the top software development companies, as well as:

  1. Top Enterprise Software Development Companies
  2. Top Custom Software Development Companies for Small Business
  3. Top Mobile App Development Companies
  4. Top AI Development Companies
  5. Top Software Testing Companies

Our design experts also recognize the most innovative design projects across the globe. Given the recent uptick in app usage, you'll want to visit our Awards section for the best & latest in app designs.

👍👎💗🤯

Frequently Asked Questions

What are the most important questions to ask a software development company?

Ask who will build your product, how the agency will manage delivery, and what your business will own after handover.

Request a project that went badly and an explanation of how the team handled it. Strong answers include relevant evidence and commitments the agency will put in writing.

How should I evaluate an agency’s portfolio?

Request a live or anonymized walkthrough and clarify what the agency built, what the client supplied, and how it measured results.

Useful questions to ask software developers include which constraints shaped the solution, what went wrong, and what they would change today. Ask to meet the technical lead where possible.

Should I sign a fixed-price contract?

Fixed price works for small, well-specified scopes. For evolving products, paid discovery followed by time and materials with a budget cap usually gives more control. Have counsel review the terms.

How do I know knowledge transfer actually happened?

Run the Monday test before final payment: your team deploys a small fix without the agency's help. If they can't, the handover isn't done.

Can I switch agencies mid-project?

Only easily if you already own the repository, cloud accounts, and documentation. That's why ownership belongs in the contract before work starts.

What evidence should an agency provide before signing?

Request relevant delivery examples, proposed team roles and availability, estimate assumptions, testing and acceptance plans, security practices, and ownership and handover terms.

Accept appropriate anonymized evidence when confidentiality prevents the agency from sharing a client’s materials.

Who owns the source code and third-party components?

The agreement should distinguish custom work, retained agency components, and third-party software.

Confirm your rights to use, modify, and transfer the relevant assets, along with access and handover timing. Repository access alone does not establish ownership rights.

How should we compare agency pricing proposals?

Give agencies a common brief, then compare included scope, assumptions, staffing, acceptance, change handling, recurring expenses, and support. Ask what could change the estimate and who approves additional spending. A lower headline price may include fewer deliverables or responsibilities.

Do we need an internal technical team to evaluate an agency?

You need someone capable of checking the technical evidence and explaining the trade-offs to your decision-makers. That can be an internal technical lead or an independent adviser.

Keep responsibility for business priorities, budget approvals, and acceptance with named people in your organization.

What should a software development contract include?

Your questions for a software development company should translate into written terms covering staffing, scope, acceptance, pricing, change approval, ownership, confidentiality, security, support, and handover.

Specify access and exit deliverables, then review the agreement with counsel to check that it reflects the agency’s promises.

Latest Software Development Trends
Receive our NewsletterJoin over 70,000 B2B decision-makers growing their brands
